Executive Summary
Mott MacDonald
Hong Kong Ltd. (“MMHK”) has been commissioned by Heng Shung Construction Co.
Ltd. to undertake the Environmental Team (ET) services to carry out
environmental monitoring and audit (EM&A) for both pre-construction and
construction phases of the Proposed Comprehensive Development at Wo Shang Wai,
Yuen Long.
This is the 11th
EM&A report submitted under the Condition 4.5 of Environmental Permit No.
EP-311/2008/B. This report summarises the findings on EM&A during the
period from 1 March to 31 March 2011.
Exceedance of Action and Limit
Levels
There was no
breach of Action or Limit levels for Air Quality (1-hr TSP and 24-hr TSP) and
Noise level (as Leq) in the reporting month.
Exceedances of pH were frequently observed at MP1 to MP3 and were exceeded a few times at MP4 to MP6. On the other hand, DO exceedances were repeatedly found at MP3 during the period. The summary of measured water quality is presented in Section 3.2.3.
Investigations have been carried out
to identify the causes of exceedance. From investigation, the Contractor has
implemented water quality mitigation measures as recommended in the EIA report.
With external factors affect the adjacent environments,
such as natural variations and pond fish culture activities, the exceedances
were considered not due to construction works.
Implementation of mitigation
measures
Site audits were carried out on
2, 9, 16 and 25 March 2011 to
confirm the implementation measures undertaken by the Contractor in the
reporting month. The outcomes are presented in Section 6 and the status of implementation of mitigation measures
in the site is shown in Appendix K.
Record of Complaints
On 17 March 2011, a complaint was lodged with
the Environmental Protection Department (EPD) on dust impact near Mai Po San
Tsuen and
Nevertheless, recommendations were provided to the Contractor to further
enhance the dust suppression within the site.
Record of Notification of summons
and successful prosecution
There was no
record of Notification of summons and successful prosecution in the reporting month.
Reporting Changes
There are no
changes to be reported the reporting month.
Future Key Issues
The
major site works to be commissioned in the coming month include Installation
of Band Drain, Trial
Embankment
for Ground Improvement and Site Formation (Filling). Potential environmental
impacts due to the construction activities, including air quality, noise, water
quality, ecology and landscape and visual, will be monitored.
Environmental mitigation measures will be
implemented on site as recommended and weekly site audits will be carried out
to ensure that the environmental conditions are acceptable.
In March 2005, the Project Proponent, Profit
Point Enterprises Limited, acquired the development site in Yuen Long at
Wo Shang Wai. An Environmental Impact Assessment (EIA) was carried out under the
EIA Ordinance (EIAO) since then and the Environmental Permit (EP-311/2008B) for
construction of the comprehensive development in Wo Shang Wai was granted by
EPD on 29 July 2010. The Project involves the residential development and associated
infrastructure and wetland restoration area and linear
landscape area. The construction works under the Environmental Permit commenced
on 12 May 2010.
Heng Shung Construction Co. Ltd. was commissioned as the Contractor for the Project. Mott MacDonald Hong Kong Ltd. (“MMHK”) has been commissioned by Heng Shung Construction Co. Ltd. to undertake the Environmental Team (ET) services to carry out environmental monitoring and audit (EM&A) for both pre-construction and construction phases of the Proposed Comprehensive Development at Wo Shang Wai, Yuen Long.
According to the EP Condition 4.5, the monthly EM&A Report shall be submitted to the Director within 2 weeks after the end of the reporting month. This report summarises the findings during the period from 1 March 2011 to 31 March 2011.
The
organisation chart and lines of communication with respect to the on-site
environmental management structure together with the contact information of the
key personnel are shown in Appendix A.
During the reporting period, construction works
of the Project undertaken include:
¡
Band
drain installation;
¡
Trial
Embankment for Ground Improvement;
and
¡
Site
formation (Filling)
The Construction Works Programme of the
Project is provided in Appendix B. The
general layout plan of the Project site is shown in Figure 1.1.
The EM&A programme requires environmental monitoring of air quality, noise, water quality, ecology and landscape and visual as specified in the approved EM&A Manual.
A summary of impact EM&A requirements is presented in Table 1.1:
Table 1.1: Summary of Impact EM&A Requirements
|
Parameters |
Descriptions |
Locations |
Frequencies |
|
Air Quality |
24-Hour TSP |
ASR1, ASR2A, ASR3, ASR4 |
Once every 6 days |
|
1-Hour TSP |
ASR1, ASR2A, ASR3, ASR4 |
3 times every 6 days |
|
|
Noise |
Leq, 30min |
NSR1, NSR3, NSR5, NSR7 |
Weekly |
|
Water Quality |
Dissolved Oxygen (DO), temperature, pH, suspended solids (SS) and Biological Oxygen Demand (BOD) |
MP1 to MP6 |
3 days per week |
|
Ecology |
Birds |
Within the Project Area and Assessment Area of 500m |
Weekly |
|
Dragonflies and Butterflies |
Within the Project Area and Assessment Area of 500m |
Once per month during Mar and Sep to November, and twice per month during Apr to Aug |
|
|
Herpetofauna |
Within the Project Area and Assessment Area of 500m |
Once per month during Apr to Nov |
|
|
Water quality of WRA |
Wetland Restoration Area |
After filling of WRA with water, monthly for in situ water quality and every size months (end of wet season and end of dry season) for laboratory testing |
|
|
Site Inspections |
Within the Project Area and Assessment Area of 500m |
Weekly |
|
|
Landscape and Visual |
Auditing of protection of existing trees,
the transplanting of existing trees, the creation of new wetland, the
planting of new trees and shrubs and other landscape and visual mitigation
measures |
CM1
to CM10 and OM1 to OM7 within the Project Area |
Site inspections once every two weeks
during construction phase; once every two months during operational phase |
The Environmental Quality Performance Limits for air quality, noise and water quality are shown in Appendix C.
The
Event and Action Plan for air quality, noise
and water quality are shown in Appendix D.
The monitoring schedule for the reporting
month is shown in Table 1.2 below:

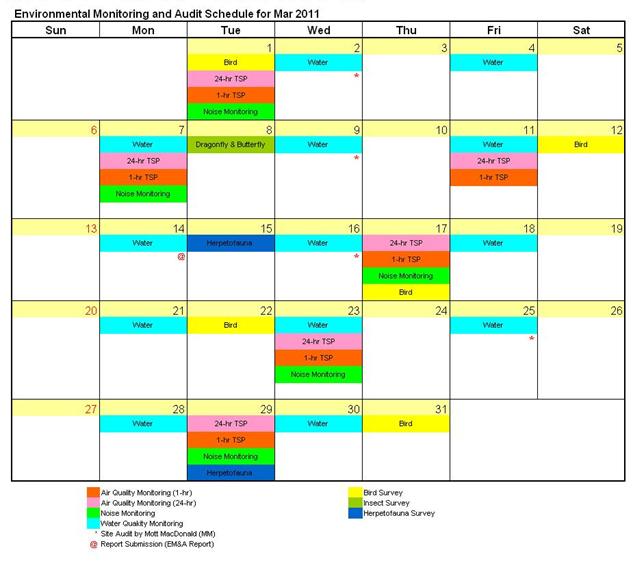

Table 1.2: Environmental Monitoring and Audit Schedule for March 2011
2.
Impact Monitoring Methodology
|
For air
quality, construction noise and water quality, ecology,
landscape and visual monitoring methodology, including the monitoring
locations, monitoring equipments used, monitoring parameters, and frequency and
duration etc., are detailed in this Chapter.
In accordance with the EM&A Manual, 1-hour and 24-hour TSP levels monitoring are to be conducted during the construction phase. Table 2.1 summarizes the monitoring parameters, frequency and duration of air quality monitoring.
Table 2.1: Air Quality Monitoring Parameters, Frequency and Duration
|
Parameter |
Frequency and Duration |
|
|
ASR1, ASR2A, ASR3 & ASR4 |
24-hour TSP |
At least once in every six-days |
|
1-hour TSP |
3 times every six-days |
The
4 air quality monitoring stations were established in the EM&A manual and
were slightly adjusted during the baseline monitoring phase. Locations of the
agreed air quality monitoring stations are listed in Table 2.2 and as shown in Figure
2.1.
Table 2.2: Air monitoring stations
|
Monitoring Stations |
Locations |
|
ASR1 |
Works Site Boundary |
|
ASR2A |
At the rooftop of refuse collection point, which
is located at the southwest of the project area |
|
ASR3 |
At the commercial centre at |
|
ASR4 |
Works Site Boundary |
Continuous 24-hour TSP air quality
monitoring is
conducted using High Volume Sampler (HVS) (Model: GMWS-2310 Accu-vol). The HVS
meets all the requirements of the EM&A Manual. Portable direct reading dust
meters were used to carry out the 1-hour TSP monitoring. Table 2.3 summarizes the equipment used in the impact
air quality monitoring.
Table 2.3: TSP Monitoring Equipment
|
Equipment |
Model |
|
24-hr TSP monitoring |
|
|
High Volume
Sampler |
GMWS 2310
Accu-vol |
|
Calibrator |
GMW 25 |
|
1-hr TSP monitoring |
|
|
Portable direct
reading dust meter |
AM510 SidePak
Personal Aerosol Monitor |
24-hour
TSP Monitoring
Installation
The HVS was installed in the vicinity of the air sensitive receiver. The following criteria were considered in the installation of the HVS.
· A horizontal platform with appropriate support to secure the sampler against gusty wind was provided.
· The distance between the HVS and any obstacles, such as buildings, was at least twice the height that the obstacle protrudes above the HVS.
· A minimum of 2 meters separation from walls, parapets and penthouse was required for rooftop sampler.
· A minimum of 2 meters separation from any supporting structure, measured horizontally was required.
· No furnace or incinerator flues or building vent were nearby.
· Airflow around the sampler was unrestricted.
· The sampler has been more than 20 metres from any drip line.
· Permission was obtained to set up the samplers and to obtain access to the monitoring stations.
· A secured supply of electricity is needed to operate the samplers.
Preparation of Filter Papers
· Glass fibre filters, were labelled and sufficient filters that were clean and without pinholes were selected.
· All filters were equilibrated in the conditioning environment for 24 hours before weighing. The conditioning environment temperature was around 25 °C and not variable by more than ±3 °C with relative humidity (RH) < 50% and was not variable by more than ±5 %. A convenient working RH was 40%.
Field Monitoring
· The power supply was checked to ensure the HVS works properly.
· The filter holder and the area surrounding the filter were cleaned.
· The filter holder was removed by loosening the four bolts and a new filter, with stamped number upward, on a supporting screen was aligned carefully.
· The filter was properly aligned on the screen so that the gasket formed an airtight seal on the outer edges of the filter.
· The swing bolts were fastened to hold the filter holder down to the frame. The pressure applied should be sufficient to avoid air leakage at the edges.
· The shelter lid was closed and was secured with the aluminium strip.
· The HVS was warmed-up for about 5 minutes to establish run-temperature conditions.
· A new flow rate record sheet was set into the flow recorder.
· The flow rate of the HVS was checked and adjusted at around 1.1 m3/min. The range specified in the EM&A Manual was between 0.6-1.7 m3/min.
· The programmable timer was set for a sampling period of 24 hrs + 1 hr, and the starting time, weather condition and the filter number were recorded.
· The initial elapsed time was recorded.
· At the end of sampling, the sampled filter was removed carefully and folded in half length so that only surfaces with collected particulate matter were in contact.
· It was then placed in a clean plastic envelope and sealed.
· All monitoring information was recorded on a standard data sheet.
· Filters were sent to a HOKLAS accredited laboratory for analysis.
Maintenance and Calibration
· The HVS and its accessories are maintained in good working condition, such as replacing motor brushes routinely and checking electrical wiring to ensure a continuous power supply.
· HVSs were calibrated at 2-month intervals.
· Calibration records for HVSs are shown in Appendix E.
1-hour
TSP Monitoring
Field Monitoring
The measuring procedures of the 1-hour dust meter are in accordance with the Manufacturer’s Instruction Manual as follows:
·
Set POWER to “ON”, push
· Push the knob at MEASURE position.
· Push “O-ADJ” button. (Then meter’s indication is 0).
· Push the knob at SENSI ADJ position and set the meter’s indication to S value described on the Test Report using the trimmer for SENSI ADJ.
· Pull out the knob and return it to MEASURE position.
· Push “START” button.
Maintenance and Calibration
· The 1-hour dust meter would be checked at 3-month intervals and calibrated at 1-year intervals throughout all stages of the air quality monitoring.
· Calibration records for direct dust meters are shown in Appendix E.
Following the requirements in the EM&A Manual for noise, noise monitoring has to be carried out during the construction phase. Continuous noise monitoring for the A-weighted levels Leq, L10 and L90 is undertaken once per every week.
Table 2.4 summarizes the monitoring parameters, frequency and duration of air quality monitoring.
Table 2.4: Noise Monitoring Parameters, Frequency and Duration
|
Monitoring Stations |
Parameter |
Frequency and Duration |
|
NSR1, NSR3, NSR5, NSR7 |
Leq, L90 & L10 |
Once every week |
The
4 noise
quality monitoring stations were established in the EM&A manual and were
slightly adjusted during the baseline monitoring phase. Locations of the agreed
noise
quality monitoring stations are listed in Table
2.5 and as shown in Figure
2.2.
Table 2.5: Noise monitoring stations
|
Monitoring Stations |
Locations |
Type of measurement |
|
NSR1 |
Noise monitoring equipment was set up near the
boundary wall at |
Free-field |
|
NSR3 |
The monitoring station was located next to the
guard house at |
Facade |
|
NSR5 |
The monitoring station was located within the work
site boundary. |
Free-field |
|
NSR7 |
The monitoring station was located near the
boundary wall of the house of Mai Po San Tsuen. |
Free-field |
Integrating Sound Level Meter will be used for noise monitoring. It is a Type 1 sound level meter capable of giving a continuous readout of the noise level readings including equivalent continuous sound pressure level (Leq) and percentile sound pressure level (Lx). They comply with International Electrotechnical Commission Publications 651:1979 (Type 1) and 804:1985 (Type 1). Table 2.6 summarizes the noise monitoring equipment model being used.
Table 2.6: Noise Monitoring Equipment
|
Monitoring locations |
Equipment Model |
|
|
Integrating Sound
Level Meter |
Calibrator |
|
|
NSR1 |
Rion NL-31 |
Rion NC-74 |
|
NSR3 |
||
|
NSR5 |
||
|
NSR7 |
||
Field Monitoring
· The Sound Level Meter was set on a tripod at a height of at least 1.2 m above the ground.
· Façade and free-field measurements were made at the monitoring locations.
· The battery condition was checked to ensure the correct functioning of the meter.
· Parameters such as frequency weighting, the time weighting and the measurement time were set as follows:
- frequency weighting: A
- time weighting: Fast
- time measurement: 30 minutes intervals (between 0700 and 1900)
· Prior to and after each noise measurement, the meter was calibrated using a Calibrator for 94 dB at 1 kHz. If the difference in the calibration level before and after measurement was more than 1 dB, the measurement would be considered invalid has to be repeated after re-calibration or repair of the equipment.
· During the monitoring period, the Leq, L10 and L90 were recorded. In addition, any site observations and noise sources were recorded on a standard record sheet.
Maintenance and Calibration
· The microphone head of the sound level meter and calibrator is cleaned with soft cloth at quarterly intervals.
·
The meter and calibrator are sent to the
supplier or HOKLAS laboratory to check and calibrate at yearly intervals.
·
Calibration records are shown in Appendix E.
In
accordance with the requirements in the EM&A Manual for water quality, water quality parameters including Dissolved Oxygen
(DO), temperature, pH, turbidity, suspended solids (SS) and Biochemical Oxygen
Demand (BOD) have to be monitored at designated monitoring stations during
construction of the Project. DO, temperature and
pH were measured in-situ whereas SS and BOD were analysed in a laboratory. The measurements should be taken at all designated monitoring
stations, 3 days per week. The interval between any two sets of monitoring was
not less than 36 hours. Table 2.7 summarizes
the monitoring parameters, frequency and duration of water quality monitoring.
Table 2.7: Water Quality Monitoring Parameters, Frequency and Duration
|
Monitoring Stations |
Parameter |
Frequency and Duration |
|
MP1, MP2, MP3, MP4, MP5
& MP6 |
DO, temperature, pH, SS,
turbidity, BOD |
Three days every week |
The
6 water quality monitoring stations were
established in the EM&A manual. Locations of the agreed water quality monitoring stations are listed in
Table 2.8
and as shown in Figure
2.3.
Table 2.8: Water quality monitoring stations
|
Monitoring Stations |
Easting |
Northing |
|
MP1 |
838 730.50 |
822 862.25 |
|
MP2 |
838 933.26 |
823 247.41 |
|
MP3 |
839 107.17 |
823 596.84 |
|
MP4 |
839 286.14 |
823 638.55 |
|
MP5 |
839 134.35 |
823 722.99 |
|
MP6 |
839 063.02 |
823 842.25 |
The Water Quality Monitoring Equipments and Analytical Methods applied to Water Quality Samples are given in Table 2.9 and Table 2.10 respectively. Details of which are discussed below.
Table 2.9: Water Quality Monitoring Equipments
|
Equipment |
Model |
Equipment /Serial Number |
|
Dissolved oxygen, temperature & pH Measuring Meter |
YSI Professional Plus |
10D101566 |
|
Turbidimeter |
Hach 2100Q |
09120C000514 |
|
Global Positioning System (GPS) |
Garmin eTrex
|
ENO 007 |
Table 2.10: Analytical Methods applied to Water Quality Samples
|
Determinant, unit |
Standard Method |
|
Total Suspended Solids, mg/L |
In house method based on APHA 2540D; ALS Method Code: EA-025 |
|
Biochemical Oxygen Demand (BOD), mg/L |
In house method based on APHA 5210B; ALS Method Code: EP-030 |
All
in-situ monitoring instruments were checked, calibrated and certified by a
laboratory accredited
under HOKLAS or any other international accreditation scheme before use.
Dissolved
Oxygen (DO), temperature and pH measuring equipment
A portable, weatherproof multiparameter instrument YSI 556 MPS was used in the monitoring. It can be capable for measuring dissolved oxygen (DO), pH, and temperature simultaneously with the following limits:
· a dissolved oxygen level in the range of 0-50 mg/L and 0-500 % saturation;
· a temperature of -5 to 45 degree Celsius; and
· pH value of 0-14 with 0.1 as the base unit.
Turbidity
Measurement Instrument
Portable and weatherproof turbidity meter (HACH model 2100P) was used during impact monitoring. It has a photoelectric sensor capable of measuring turbidity between 0-1000 NTU. Response of the sensor was checked with certified standard turbidity solutions before the start of measurement.
Global
Positioning System
A
hand-held GPS navigator (Garmin eTrex
Suspended Solids and BOD Measurements (Sample
Containers and Storage)
Water samples for SS analysis were stored in
high density polythene bottles with no preservative added, packed in ice
(cooled to 4oC without being frozen), delivered to the laboratory, and
analysed as soon as possible after collection. Analysis was carried out in a
HOKLAS accredited laboratory.
Detection Limit
The limits of
detection for the in-situ and laboratory measurements are shown in Table
2.11.
Table 2.11: Detection
Limits for Water Quality Determinants
|
Determinant |
Limit of Detection |
|
Dissolved Oxygen |
0.1 mg/L |
|
Temperature |
0.1
degree Celsius |
|
pH |
0.01 unit |
|
Turbidity |
0.1 NTU |
|
Suspended Solids |
1 mg/L |
|
BOD |
2 mg/L |
In situ measurement
All pH meters, DO/ temperature meters had
been checked and calibrated prior to use. Standard buffer solution of at least
2 pH levels (either pH 4 and pH 7 or pH 7 and pH 10) had been used for
calibration of the instrument before and after use.
DO meters had been calibrated by a laboratory
accredited under HOKLAS or any other international accreditation scheme, and
subsequently re-calibrated at 3 monthly intervals throughout all stages of the
water quality monitoring. Responses of sensors and electrodes had been checked
with certified standard solutions before each use. Wet bulb calibrations for
all DO meters had been carried out before measurement at each monitoring
location. For the on site calibration of field equipment, BS 127:1993, "Guide
to field and on-site test methods for the analysis of waters" had been
observed.
Measurements shall be at 3 water depths,
namely, 1m below water surface, mid-depth and 1m above stream bed/pond bed,
except where the water depth less that 6m, the mid-depth
station maybe omitted. Should the water depth be less than 3m, only the
mid-depth station will be monitored.
Replicates in-situ measurements and samples
collected from each independent monitoring event are required for all
parameters to ensure a robust statistically interpretable dataset.
Water Samples Preparation and Analysis
For collection of water sampling within the
water courses, a 500ml clean plastic beaker was used. After collection, the
water samples were stored in high-density polythene bottles. The sample
container was rinsed with a portion
of the water sample. The water sample was then transferred to the container,
labelled with a unique sample ID and sealed with a
screw cap. The water samples were stored in a cool box maintained
at 4oC. The water samples were then delivered to a local
HOKLAS-accredited laboratory (ALS) on
the same day for analysis.
The testing methods of testing parameters as
recommended by EIA or required by EPD,
with the QA/QC results are in accordance with the requirement of HOKLAS or
international accredited scheme.
The calibration certificates for equipments used for in-situ
monitoring of water quality are attached in Appendix E.
Target species and certain other fauna will
be monitored within the Project Area and Assessment Area during the wetland and
residential construction phase. This will be important to ensure that any
unexpected events or impacts either on- or off-site are quickly identified so
that remedial action can be taken. The
groups to be monitored and frequency of monitoring are shown in Table 2.12.
Table 2.12: Summary of Construction Phase Ecological Monitoring
for the Wo Shang Wai WRA
|
|
Construction
Phase Ecological Monitoring |
|
Birds |
Weekly (including Assessment
Area). |
|
Dragonflies and Butterflies |
Once per month during March
and September to November, and twice per month during April to August. |
|
Herpetofauna |
Once per month during April
to November. |
|
Water Quality |
After filling of WRA with
water, monthly for in situ water
quality and every six months (end of the wet season and end of the dry
season) for laboratory testing. |
|
Site Inspections |
Weekly. |
Ecological
monitoring locations during
construction phase are shown in Figure 4.1 and the methodology for ecological monitoring
is detailed in Section 4.
·
The extent of the agreed works area should be regularly
checked during the construction phase. Any trespass by the Contractor outside
the limit of the works, including any damage to existing trees and woodland
shall be noted;
·
The progress of the engineering works should be regularly
reviewed on site to identify the earliest practical opportunities for the
landscape works to be undertaken;
·
All existing vegetation, streams and other features within
the study area which are not directly affected by the works are retained and
protected;
·
The methods of protecting existing vegetation proposed by the
Contractor are acceptable and enforced;
·
Preparation, lifting transport and re-planting operations for
any transplanted trees;
·
The layout, design and construction of buildings conforms to
requirements specified in the EIA report;
·
All landscaping works are carried out in accordance with the
EIA recommendations and with specifications;
·
The planting of new trees, shrubs, groundcover, climbers,
grasses and other plans, together with the replanting of any transplanted trees
are carried out properly and within the right season;
·
All necessary horticultural operations and replacement
planting are undertaken throughout the Establishment Period to ensure the
healthy establishment and growth of both transplanted trees and all newly
establishment plants.
Table 2.13: Construction and Operation
Phase Audit Checklist
|
Area of Works |
Items to be Monitored |
|
Works Area |
Check the extent of the Works to ensure that the Works Area
is not exceeded |
|
Protection of all trees and woodland blocks to be retained |
Identification and demarcation of trees / vegetation to be
retained, erection of physical protection (e.g. fencing), monitoring against
possible incursion, physical damage, fire, pollution, surface erosion, etc. |
|
Streams |
Ensure no run-off into existing streams |
|
Clearance of existing vegetation |
Identification and demarcation of trees / vegetation to be
cleared, checking of extent of works to minimize damage, monitoring of
adjacent areas against possible incursion, physical damage, fire, pollution,
surface erosion, etc. |
|
Transplanting of trees |
Identification and demarcation of trees / vegetation to be
transplanted, monitoring of extent of pruning / lifting works to minimize
damage, timing of operations implementation of all stages of preparatory and
translocation works, and maintenance of transplanted vegetation, etc. |
|
Topsoil stripping |
Ensuring existing topsoil is stripped and stored under
recognized good practice and is hydroseeded and regularly turned to prevent
anaerobic conditions |
|
New buildings |
Ensure that building finishes accord with mitigation
proposals with regard to colour and albedo. |
|
Boundaries |
Ensuring hoarding are erected as required |
|
Noise Barrier |
Ensure noise barrier design accords with the mitigation
proposals with regard to location, materials and finishes. |
|
Night-time lighting |
Ensuring night-time lighting is directional, hooded and
shielded away from VSRs |
|
Plant supply |
Monitoring of operations relating to the supply of
specialist plant material (including the collecting, germination and growth
of plants from seed) to ensure that plants will be available in time to be
used within the construction works. |
|
Landscape and wetland treatments generally |
Check that wetland, and hard / soft landscape designs
conform to intent of mitigation measures and agreed designs |
|
Soiling, planting, etc. |
Monitoring of implementation and maintenance of soiling and
planting works against possible incursion, physical damage, fire, pollution,
surface erosion, etc. |
|
Establishment Works |
Monitoring of implementation of maintenance operation
during Establishment Period |
The monitoring locations should check
against the mitigation measures proposed under the approved Environmental
Impact Assessment, which are summarised as follows:
Table 2.14: Proposed Construction Phase
Mitigation Measures
|
ID No. |
Landscape and Visual
Mitigation Measure |
|
CM1 |
The construction area and contractor’s temporary works
areas should be minimised to avoid impacts on adjacent landscape. |
|
CM2 |
Screening of construction works by hoardings/noise barriers
around Works area in visually unobtrusive colours, to screen Works. |
|
CM3 |
Reduction of construction period to practical minimum. |
|
CM4 |
Topsoil, where identified, should be stripped and stored for
re-use in the construction of the soft landscape works, where the soil
material meets acceptable criteria and where practical. The Contract Specification shall include
storage and reuse of topsoil as appropriate. |
|
CM5 |
Hydroseeding or sheeting of soil stockpiles with visually
unobtrusive material (in earth tone). |
|
CM6 |
Advance screen planting to noise barriers. |
|
CM7 |
Control night-time lighting and glare by hooding all
lights. |
|
CM8 |
Ensure no run-off into streams adjacent to Project Area. |
|
CM9 |
Protection of existing trees on boundary of project area
shall be carefully protected during construction. Detailed Tree Protection Specification
shall be provided in the Contract Specification. Under this specification,
the Contractor shall be required to submit, for approval, a detailed working
method statement for the protection of trees prior to undertaking any works
adjacent to all retained trees, including trees in contractor’s works
areas. (Tree protection measures will
be detailed at S16 and Tree Removal Application stage). |
|
CM10 |
Trees unavoidably affected by the works shall be
transplanted where practical. Trees
should be transplanted straight to their destinations and not held in a
nursery. A detailed Tree Transplanting
Specification shall be provided in the Contract Specification, if applicable.
Sufficient time for necessary tree root and crown preparation periods shall
be allowed in the project programme. |
Table 2.15: Proposed Operation Phase
Mitigation Measures
|
ID
No. |
Landscape
Mitigation Measure |
|
OM1 |
Compensatory Tree Planting for all felled trees shall be
provided to the satisfaction of relevant Government departments. Required numbers and locations of
compensatory trees shall be determined and agreed separately with Government
during the Tree Felling Application process under ETWBTC 3/2006. |
|
OM2 |
A continuous belt of screen planting along southern
perimeter of project area with fast growing tree species. At least 450 trees capable of reaching a
height > 10m within 10 years should be planted. Planting of the belt of trees shall be
carried out as advance works ahead of other site formation and building
works. |
|
OM3 |
Maximise soft landscape and amenity water bodies in
residential areas of the development.
Approximately 750 of trees (of Heavy Standard size) should be
planted. Where space permits, roadside
berms should be created. Street trees should be of species that reach a
mature height of no less than 15m. |
|
OM4 |
Maximise freshwater habitat wetland creation consistent
with achieving other parameters. Min
4.74 ha to be provided. Wetlands must
have natural edge profiles with >1m wide emergent zone. No access to the wetland by residents and
all wetlands must be screened from residential development by a continuous
tree screen at interface with residential development or earth mounding such
that disturbance is minimised. Implementation of the wetland shall be carried
out as advance works. |
|
OM5 |
Use appropriate (visually unobtrusive and non-reflective)
building materials and colours in built structures. |
|
OM6 |
During detailed design, refine building layout to create a
min 10m wide gap between buildings north of Wo Shang Wai pond and also two
min 10m wide gaps in the row of buildings adjacent to Royal Palms. |
|
OM7 |
Streetscape elements (e.g. paving, signage, street
furniture, lighting etc.) shall be sensitively designed in a manner that
responds to the local context, and minimises potential negative landscape and
visual impacts. Lighting units should
be directional and minimise unnecessary light spill. |
Impact
monitoring for air quality (dust), noise and water quality due to the
construction work were undertaken during the reporting month in compliance with
the EM&A manual in the reporting period. Regular site inspections were
carried out on 2, 9, 16 and 25 March 2011 in the
reporting month to assess the compliance with environmental requirements.
Results of 1-hour TSP at the four monitoring locations are summarised in Table 3.1. Graphical plots of the monitoring results are shown in Appendix F.
Table 3.1: Summary
of 1-hour TSP monitoring results
|
Monitoring Date |
Start Time |
1-hr TSP (μg/m3) |
Range (μg/m3) |
Action Level (μg/m3) |
Limit Level (μg/m3) |
|||
|
1st Result |
2nd Result |
3rd Result |
||||||
|
ASR1 |
||||||||
|
1-Mar-11 |
9:13 |
76 |
72 |
82 |
54 - 183 |
378 |
500 |
|
|
7-Mar-11 |
8:58 |
54 |
83 |
96 |
||||
|
11-Mar-11 |
9:08 |
104 |
92 |
97 |
||||
|
17-Mar-11 |
8:47 |
109 |
106 |
98 |
||||
|
23-Mar-11 |
8:54 |
83 |
75 |
98 |
||||
|
29-Mar-11 |
8:44 |
180 |
178 |
183 |
||||
|
ASR2A |
||||||||
|
1-Mar-11 |
13:18 |
79 |
74 |
80 |
74 - 168 |
357 |
500 |
|
|
7-Mar-11 |
13:05 |
84 |
92 |
82 |
||||
|
11-Mar-11 |
13:14 |
80 |
92 |
98 |
||||
|
17-Mar-11 |
13:02 |
98 |
107 |
95 |
||||
|
23-Mar-11 |
12:47 |
133 |
142 |
150 |
||||
|
29-Mar-11 |
12:52 |
155 |
162 |
168 |
||||
|
ASR3 |
||||||||
|
1-Mar-11 |
13:04 |
68 |
98 |
89 |
68 - 165 |
358 |
500 |
|
|
7-Mar-11 |
12:50 |
100 |
103 |
99 |
||||
|
11-Mar-11 |
13:02 |
86 |
104 |
91 |
||||
|
17-Mar-11 |
12:45 |
98 |
102 |
95 |
||||
|
23-Mar-11 |
12:37 |
130 |
138 |
146 |
||||
|
29-Mar-11 |
12:39 |
161 |
158 |
165 |
||||
|
ASR4 |
||||||||
|
1-Mar-11 |
9:09 |
103 |
96 |
88 |
55 - 188 |
372 |
500 |
|
|
7-Mar-11 |
8:52 |
55 |
61 |
82 |
||||
|
11-Mar-11 |
8:57 |
95 |
112 |
106 |
||||
|
17-Mar-11 |
8:40 |
106 |
107 |
112 |
||||
|
23-Mar-11 |
8:47 |
88 |
67 |
105 |
||||
|
29-Mar-11 |
8:39 |
185 |
188 |
184 |
||||
Results of 24-hour TSP at the four monitoring locations are summarised in Table 3.2. Graphical plots of the monitoring results are shown in Appendix F.
Table 3.2: Summary
of 24-hour TSP monitoring results
|
Monitoring Date |
Monitoring Results (μg/m3) |
Range (μg/m3) |
Action Level (μg/m3) |
Limit Level (μg/m3) |
|
ASR1 |
|
|
|
|
|
1-Mar-11 |
85 |
80 - 99 |
226 |
260 |
|
7-Mar-11 |
85 |
|||
|
11-Mar-11 |
92 |
|||
|
17-Mar-11 |
99 |
|||
|
23-Mar-11 |
80 |
|||
|
29-Mar-11 |
91 |
|||
|
ASR2A |
|
|
|
|
|
1-Mar-11 |
81 |
81 - 105 |
213 |
260 |
|
7-Mar-11 |
86 |
|||
|
11-Mar-11 |
86 |
|||
|
17-Mar-11 |
105 |
|||
|
23-Mar-11 |
96 |
|||
|
29-Mar-11 |
90 |
|||
|
ASR3 |
|
|
|
|
|
1-Mar-11 |
90 |
89 - 101 |
205 |
260 |
|
7-Mar-11 |
96 |
|||
|
11-Mar-11 |
89 |
|||
|
17-Mar-11 |
101 |
|||
|
23-Mar-11 |
98 |
|||
|
29-Mar-11 |
89 |
|||
|
ASR4 |
|
|
|
|
|
1-Mar-11 |
92 |
86 - 102 |
237 |
260 |
|
7-Mar-11 |
91 |
|||
|
11-Mar-11 |
86 |
|||
|
17-Mar-11 |
96 |
|||
|
23-Mar-11 |
92 |
|||
|
29-Mar-11 |
102 |
No exceedance of 1-hour and 24-hour TSP (Action or Limit Level) was recorded in the reporting period.
The weather conditions in the reporting period are provided in Appendix G.
The construction noise monitoring results are summarized in Table 3.3. Graphical plots of the monitoring data are shown in Appendix F.
Table 3.3: Summary
of Construction noise
monitoring results
|
Monitoring Date |
Start Time |
Mean & Range
of Noise Levels, dB(A) |
Limit Level for Leq
(dB) |
||
|
Leq |
L10 |
L90 |
|||
|
NSR1 |
|
|
|
|
> 75 |
|
1-Mar-11 |
13:23 |
55 |
58 |
44 |
|
|
7-Mar-11 |
13:08 |
53 |
55 |
44 |
|
|
17-Mar-11 |
13:17 |
53 |
55 |
43 |
|
|
23-Mar-11 |
13:02 |
51 |
54 |
43 |
|
|
29-Mar-11 |
13:02 |
58 |
61 |
55 |
|
|
NSR3 |
|
|
|
|
|
|
1-Mar-11 |
14:27 |
47 |
48 |
45 |
|
|
7-Mar-11 |
14:14 |
50 |
52 |
44 |
|
|
17-Mar-11 |
14:57 |
51 |
53 |
46 |
|
|
23-Mar-11 |
14:10 |
53 |
54 |
48 |
|
|
29-Mar-11 |
14:05 |
59 |
60 |
55 |
|
|
NSR5 |
|
|
|
|
|
|
1-Mar-11 |
9:19 |
54 |
55 |
51 |
|
|
7-Mar-11 |
9:03 |
53 |
54 |
51 |
|
|
17-Mar-11 |
9:53 |
55 |
58 |
51 |
|
|
23-Mar-11 |
8:52 |
53 |
54 |
50 |
|
|
29-Mar-11 |
8:46 |
52 |
54 |
50 |
|
|
NSR7 |
|
|
|
|
|
|
1-Mar-11 |
10:27 |
64 |
66 |
60 |
|
|
7-Mar-11 |
10:17 |
64 |
66 |
60 |
|
|
17-Mar-11 |
10:58 |
65 |
67 |
61 |
|
|
23-Mar-11 |
10:14 |
66 |
68 |
62 |
|
|
29-Mar-11 |
9:58 |
66 |
69 |
62 |
|
No exceedance (Action/Limit Level) of construction noise was recorded in the reporting period.
The water quality monitoring results are summarized in Table 3.4. Graphical plots of the monitoring data are shown in Appendix F.
Table 3.4: Summary of Water quality monitoring results
|
Monitoring Date |
Temp (oC) |
pH |
Dissolved Oxygen (mg/L) |
DOS (%) |
Turbidity (NT) |
BOD (mg/L) |
Suspended Solids (mg/L) |
|
MP1 |
|
|
|
|
|
|
|
|
2/3/2011 |
17.3 |
7.7 |
5.9 |
61.9 |
82.6 |
5 |
88 |
|
4/3/2011 |
17.7 |
7.6 |
4.2 |
45.7 |
79.6 |
5.5 |
81.5 |
|
7/3/2011 |
